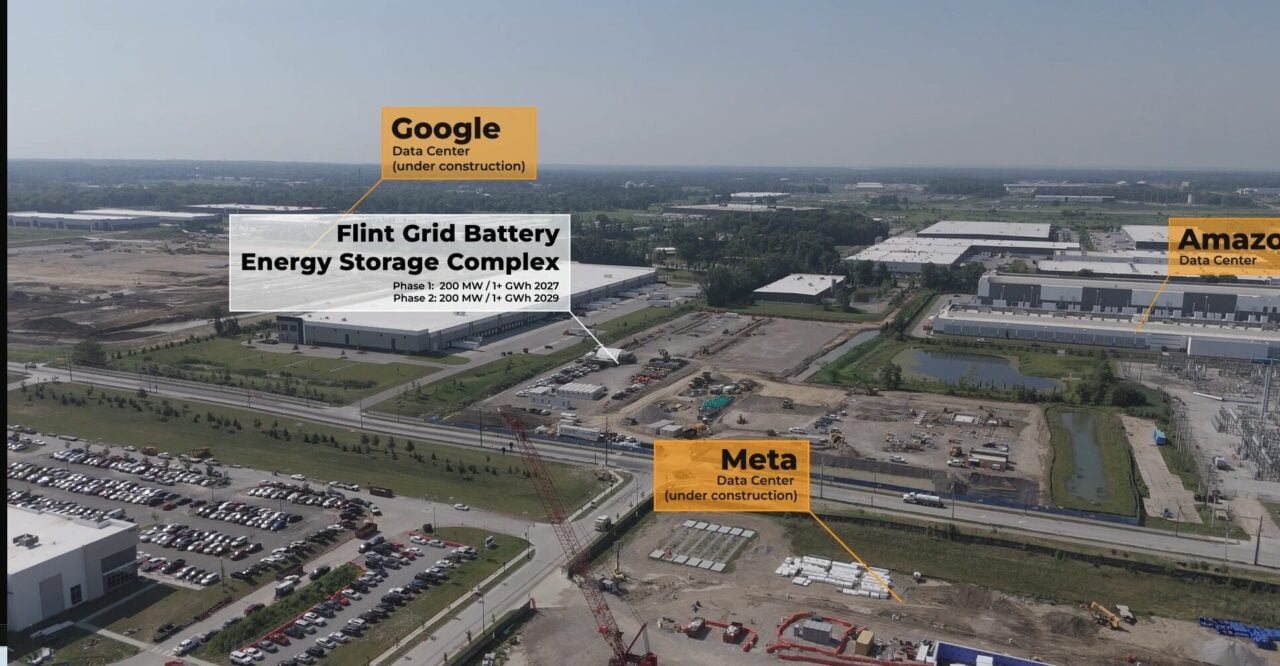

On July 30, 2026, US independent power producer Eolian officially broke ground on the Flint Grid Battery Energy Storage System in Licking County, Ohio — a 200MW/1,064MWh lithium-ion BESS that becomes the largest battery storage project ever constructed within the PJM Interconnection, the world's largest wholesale electricity market serving 65 million people across 13 states. The project represents a confluence of three structural trends: explosive data center load growth in the New Albany-Columbus corridor (where hyperscale operators have collectively committed over $30 billion in new investments), the increasing role of BESS in PJM's capacity market as fossil generators retire (battery storage won over 50% of new capacity in the 2027/28 auction), and the strategic repurposing of existing transmission infrastructure — Flint Grid connects to underutilized 138kV and 345kV corridors originally built for now-retired coal generation. CEO Aaron Zubaty emphasized that the capital commitment was secured before data center load forecasts became front-page headlines — a testament to the project's underlying fundamentals. For homeowners evaluating home battery vs generator backup to protect against grid outages, Flint Grid offers the utility-scale parallel: storage is increasingly the enabling infrastructure for economic development, grid reliability, and renewable integration at scale.
Overview of the Technology / News
The Flint Grid BESS in Licking County features 200MW/1,064MWh — approximately 5.3 hours of storage duration, notably longer than the 1-2 hour systems that characterized early PJM BESS deployments. This shift toward 4+ hour duration reflects PJM's evolving capacity accreditation framework under FERC Order 841, where longer-duration resources receive materially higher capacity accreditation and therefore higher capacity market revenue. Flint Grid is the first grid-scale BESS to receive siting approval from the Ohio Power Siting Board under a streamlined framework treating BESS as a generation facility rather than a major utility facility — reducing the siting timeline from 18-24 months to approximately 8 months.
Rather than pursuing a greenfield interconnection — which in PJM's backlogged queue (over 300GW of projects waiting, with average study timelines of 4-7 years) would have delayed operation to 2030 or beyond — Flint Grid leverages existing transmission capacity released by coal plant retirements. Ohio has retired approximately 15GW of coal since 2010, leaving transmission infrastructure in place but underutilized. This transmission-aware siting strategy avoids the cost and delay of new buildout. For system designers sizing off-grid battery system sizing — whether for off-grid cabins or whole-home backup — Flint Grid demonstrates the same principle at grid scale: siting and interconnection are as critical to project economics as the battery technology itself.
Why This Development Matters
Flint Grid represents the emergence of load-center BESS — fundamentally different from generation-adjacent BESS co-located with solar farms. Four factors make it particularly consequential:
- Data Center Load Growth: The New Albany-Columbus corridor has over 5GW of committed data center load under construction or in planning. Data center load is constant (85-95% capacity factor 24/7), growth-intensive (each new AI training cluster requires 500MW-1GW), and location-constrained (within 50 miles of internet exchange points). This combination creates an ideal revenue environment for BESS providing local capacity, voltage support, and contingency reserves.
- PJM Capacity Market Transformation: The 2027/28 Base Residual Auction cleared at a price making BESS economically viable without supplemental energy arbitrage revenue. Flint Grid accounted for over 50% of new battery capacity cleared, demonstrating BESS can compete head-to-head with natural gas peaking plants on a capacity-only basis — a structural shift from previous auctions where BESS required significant energy market revenue assumptions.
- Transmission Infrastructure Repurposing: The US has an estimated 200-300GW of underutilized transmission capacity at retired fossil fuel sites. The Department of Energy identified this as the single largest lever for accelerating clean energy deployment — capable of enabling 100-150GW within 2-3 years vs. 5-7 years for greenfield transmission. Flint Grid is a first large-scale demonstration of this approach.
- Investment Certainty: CEO Zubaty emphasized that capital was committed before data center narratives became headlines — suggesting the BESS investment thesis in PJM is robust to a range of data center growth scenarios. For homeowners considering battery management system BMS explained — where the BMS orchestrates charging, thermal management, and state-of-health monitoring — Flint Grid illustrates that grid-scale battery management requires analogous sophistication in market rules, interconnection protocols, and capacity accreditation methods.
Technical Deep Dive
PJM's Reliability Pricing Model (RPM) operates through three-year forward procurement. The capacity price in $/MW-day compensates resources for availability during Capacity Performance hours (June-September, 10AM-10PM weekdays). Under PJM's ELCC methodology adopted in 2024, BESS is accredited based on marginal reliability contribution — the probability that the BESS will have sufficient state of charge during loss-of-load risk hours. For a 5.3-hour BESS, ELCC accreditation is typically 80-95% of nameplate. At 85% accreditation, Flint Grid's 200MW translates to 170MW of UCAP, generating an estimated $25-35 million in annual capacity revenue alone — providing a stable, contract-grade revenue floor for project finance.
Beyond capacity revenue, Flint Grid will earn from PJM energy and ancillary services markets — though as the Australian NEM recently demonstrated (battery price spreads collapsed 85% year-on-year as the fleet crossed 9GW), energy arbitrage is inherently self-limiting. Flint Grid's 5.3-hour duration enables multi-hour energy shifting, day-ahead to real-time arbitrage, and participation in Synchronized Reserve and Regulation markets. The technical capability to transition between these revenue streams requires an advanced EMS with real-time price forecasting, SoC optimization, and automated bidding algorithms that re-optimize dispatch every 5 minutes. For installers evaluating energy storage inverter compatibility — matching the right inverter to battery chemistry and voltage configuration — the grid-scale parallel is the EMS-to-market interface: optimization strategy has as much impact on revenue as the choice of battery cells or inverter topology.
Real-world Applications
- Behind-the-Meter Storage for Data Centers: A 50-100MW data center campus with 4-6 hours of on-site BESS can provide UPS functionality replacing diesel generators (sub-2ms response vs. 10-15 seconds), demand charge management (reducing peak grid draw, which represents 30-40% of the electricity bill), and grid services participation during idle periods.
- C&I Storage in Load Pockets: Customers in PJM load pockets — where transmission import is constrained and LMPs are structurally higher — can deploy BESS to arbitrage locational price differentials. This congestion revenue depends on transmission constraints, not BESS saturation, and does not face the same cannibalization risk as energy arbitrage. For homeowners considering whole house battery backup solution — a whole-house system with automatic transfer switch — the load pocket analogy translates directly: a home battery creates a personal load pocket isolating the household from grid-level price volatility.
- Manufacturing and Industrial Load Centers: Ohio's industrial base — automotive, steel, chemicals — represents large, constant loads ideal for co-located BESS. A steel electric arc furnace drawing 100-150MW for 30-45 minutes creates severe voltage flicker; BESS can smooth power draw, provide reactive power compensation, and participate in demand response. The DOE's Industrial Demonstrations Program has allocated $6.3 billion for such projects.
Industry Impact / Market Implications
- PJM as the Next Big BESS Market: While CAISO and ERCOT have dominated US BESS deployment (75% of 25GW installed), PJM is poised to become the largest market by 2028-2030. The interconnection queue contains over 50GW of standalone BESS, and coal retirements (20-30GW by 2030) plus data center load growth (10-15GW) create an unprecedented investment environment. Flint Grid serves as proof of concept for dozens of developers with earlier-stage PJM projects.
- Supply Chain and Equipment: Flint Grid's 1,064MWh procurement — likely LFP cells given the 5.3-hour duration and LFP's superior cycle life and thermal stability — will be closely watched. Global LFP cell prices declined ~25% YoY in H1 2026 to $55-65/kWh, driven by Chinese overcapacity. The IRA's domestic content bonus (40%+ US-manufactured, rising to 55% by 2027) and Section 301 tariffs on Chinese batteries create strong incentives for US cell procurement.
- Insurance and Risk Management: The BESS insurance market tightened significantly following 2024-2025 thermal runaway incidents. Flint Grid's risk management — fire suppression, thermal monitoring, emergency protocols in a mixed agricultural-suburban setting — will be scrutinized as a benchmark for non-remote large-scale BESS.
- Workforce and Local Economic Impact: 200-300 construction jobs over 18-24 months, with 10-15 permanent O&M positions. The Ohio Clean Energy Workforce Initiative projects demand for 3,000-5,000 BESS technicians across Ohio by 2030.
Future Outlook
Flint Grid marks the beginning of a sustained BESS development wave in PJM. Four trends will shape the next 2-5 years: (1) capacity market price evolution — more BESS clearing the BRA will create downward price pressure, partially offset by coal retirements; (2) ELCC methodology refinement — separate accreditation curves for different storage durations as penetration increases; (3) FERC Order 2023 interconnection reforms — cluster study approach reducing timelines for projects with demonstrated transmission availability; and (4) data center co-location — the economic case for direct BESS contracting strengthening as campus loads reach 500MW+. For the residential market — where whole house battery backup solution is increasingly mainstream — Flint Grid establishes that energy storage is a core grid infrastructure component with robust economic fundamentals across demand scenarios.
